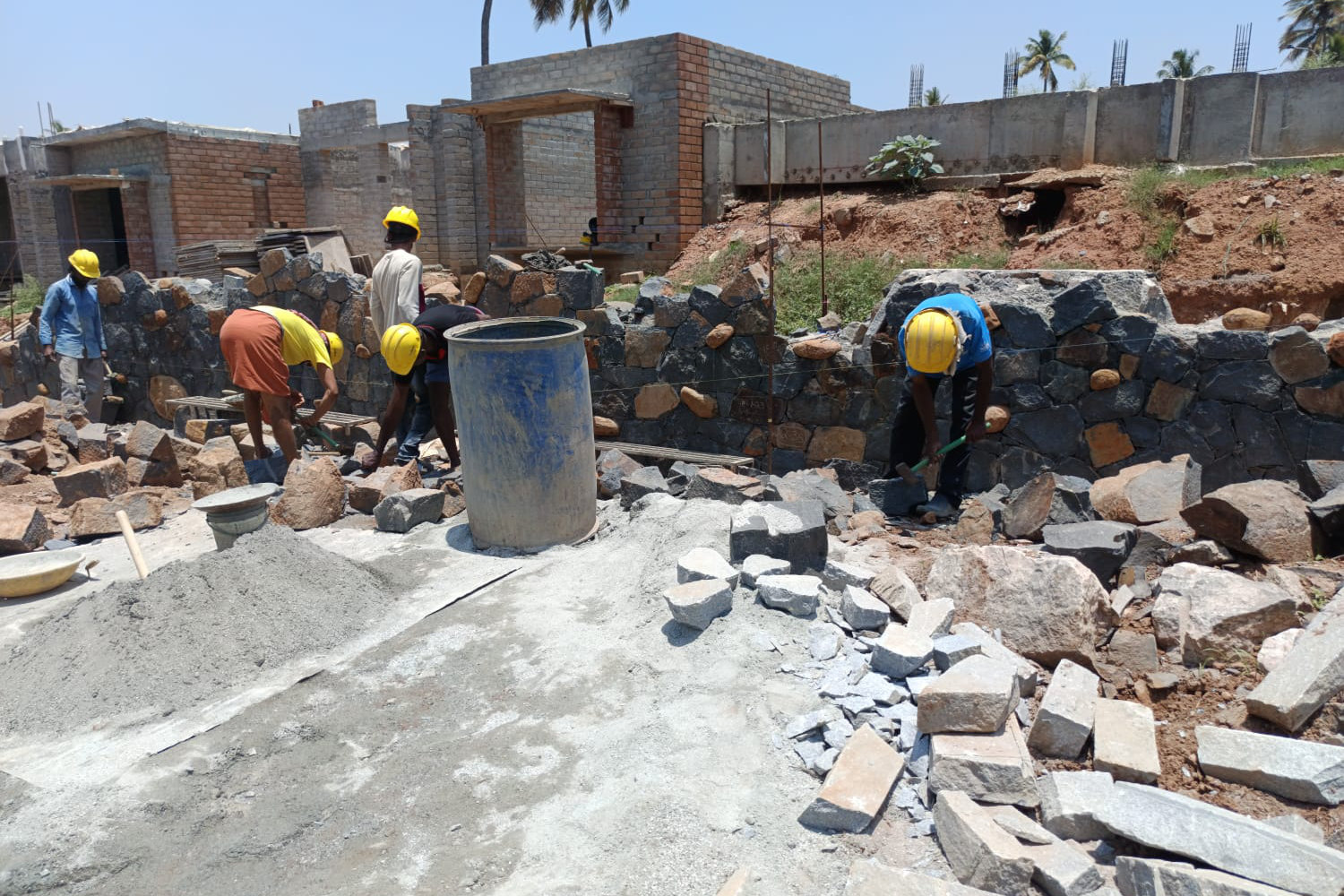

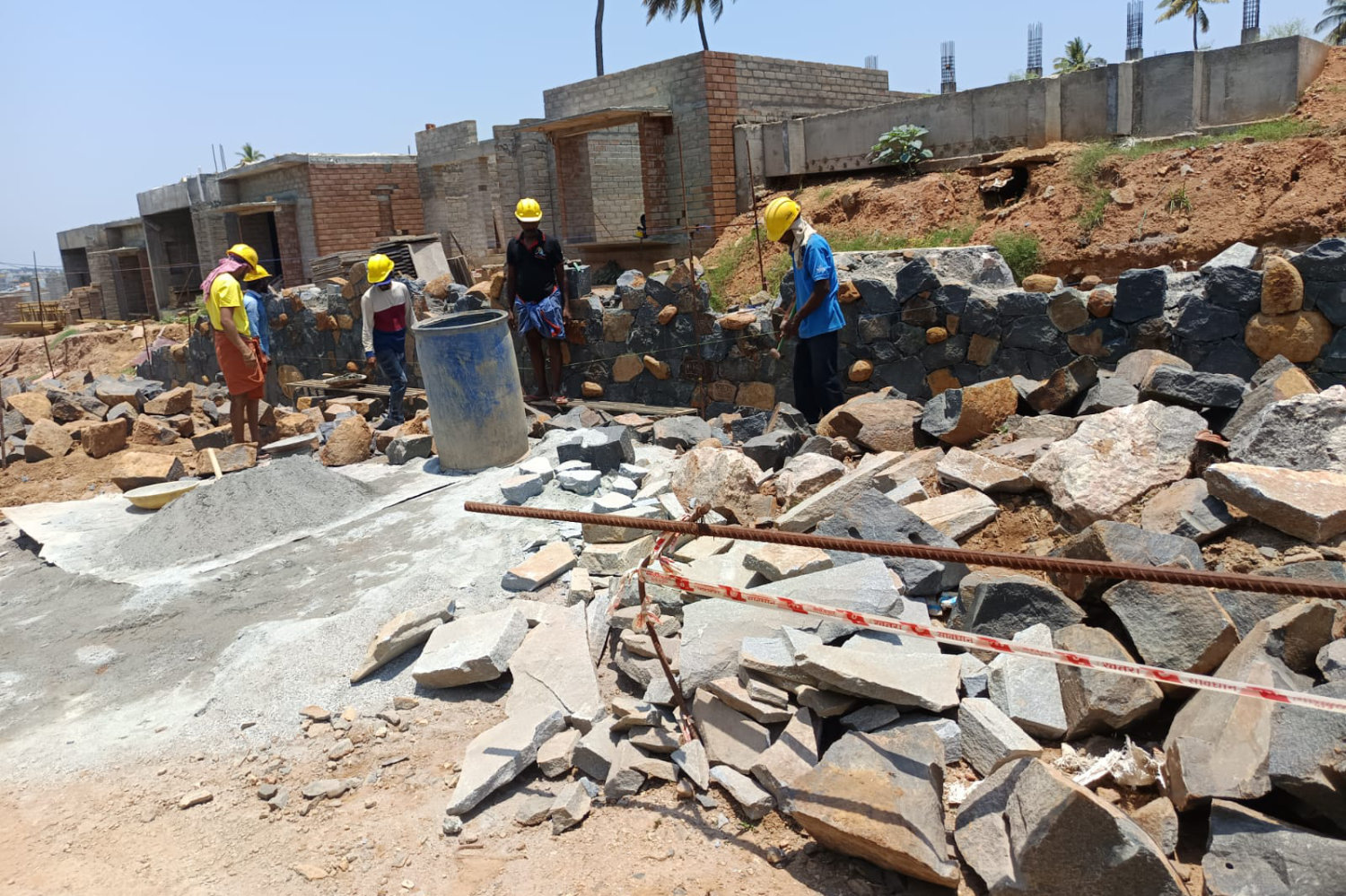

The basement roof slab work has been fully completed across all designated units, marking a major structural milestone in the project.
Block work on the ground floor is progressing steadily, with 38 units successfully completed, contributing to the structural integrity of the development.

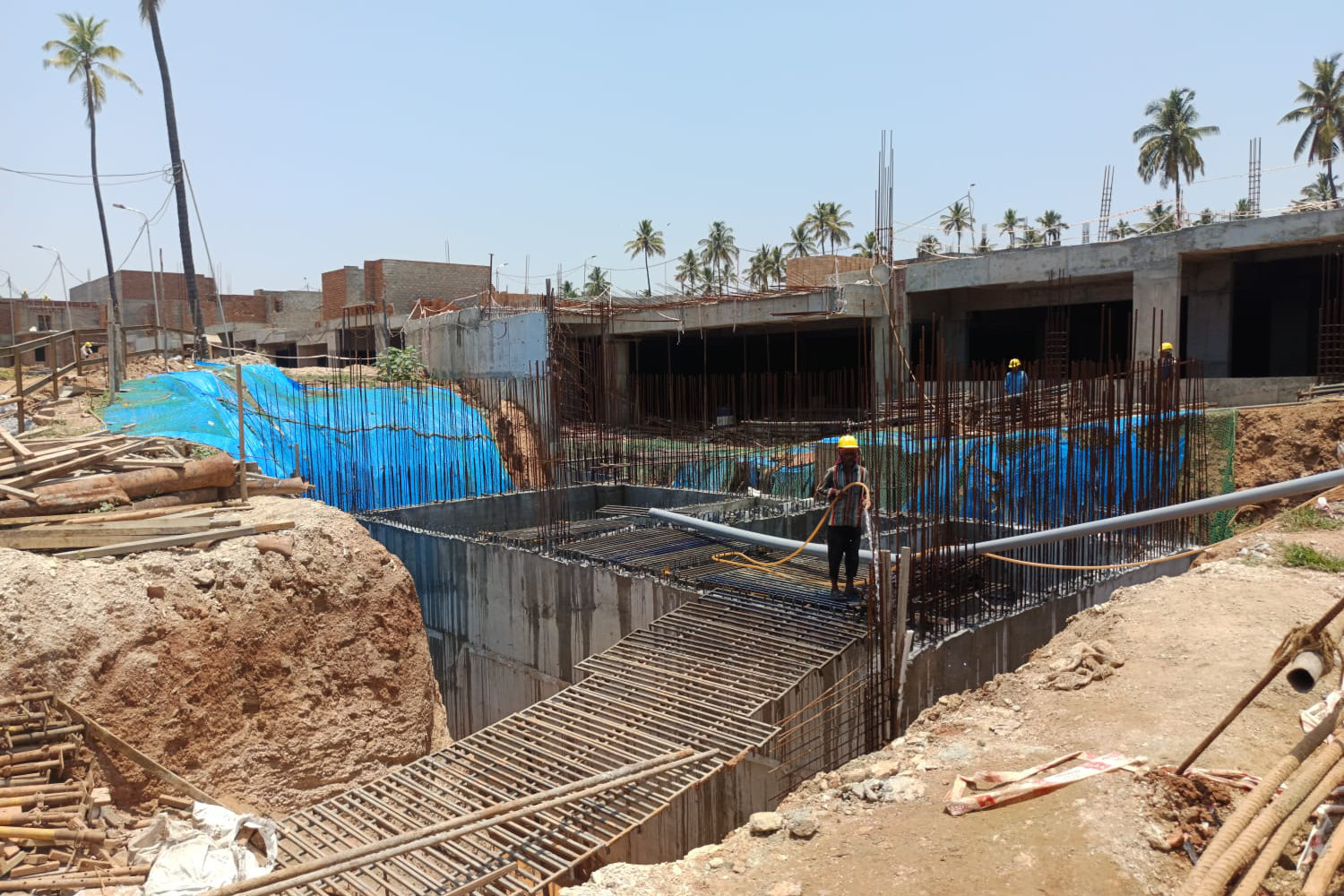

Roof slab casting on the ground floor is nearing completion, with 34 units already done, preparing the structure for upper-level construction.

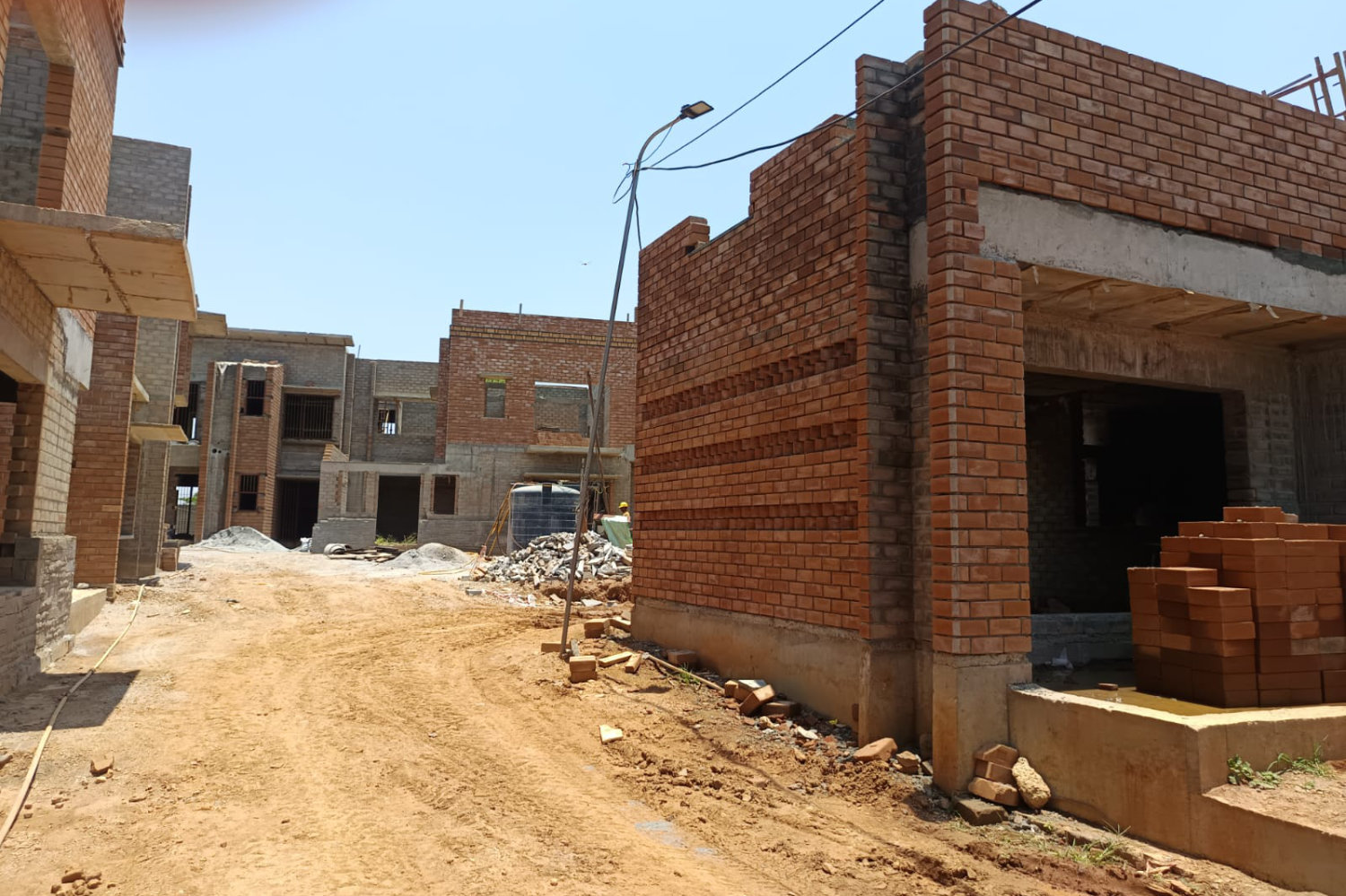

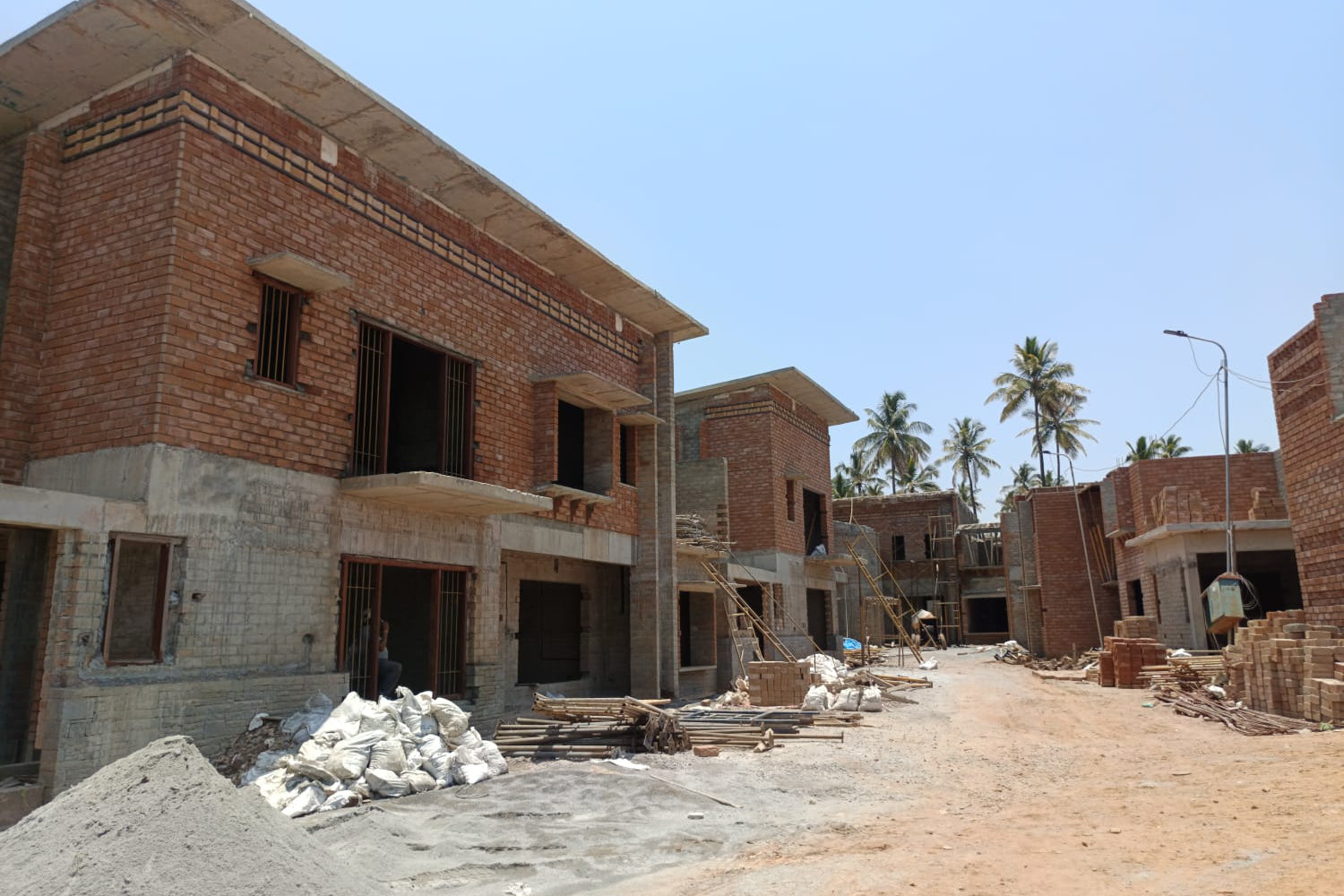

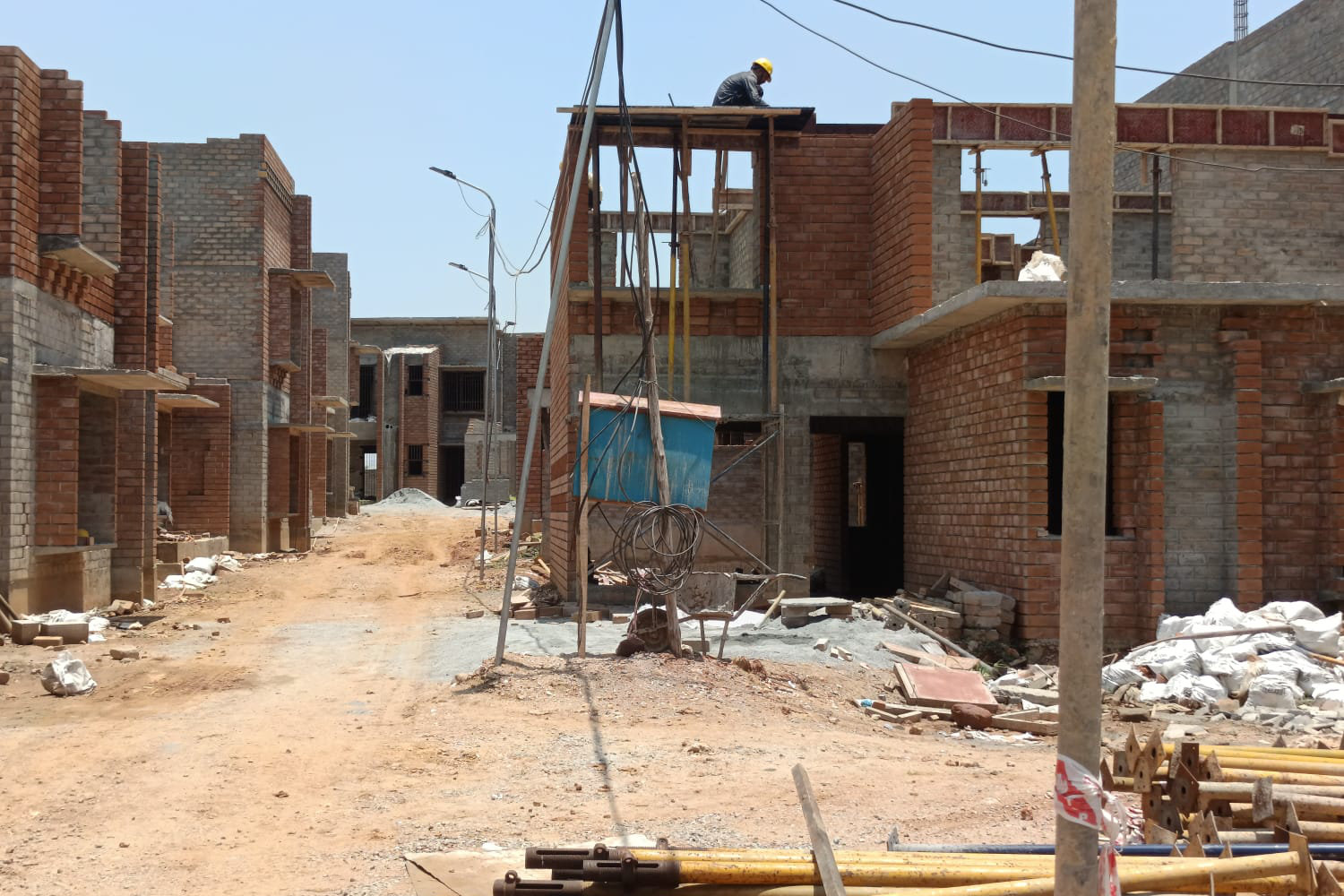

Brick work on the first floor is advancing, with 18 units completed, shaping the internal and external walls.
The roof slab for 8 units on the first floor has been cast, supporting further vertical progress on higher levels.
Internal works such as electrical conduiting and the installation of doors and windows are currently underway, aligning with the project's finishing phases.
Drone’s Eye View

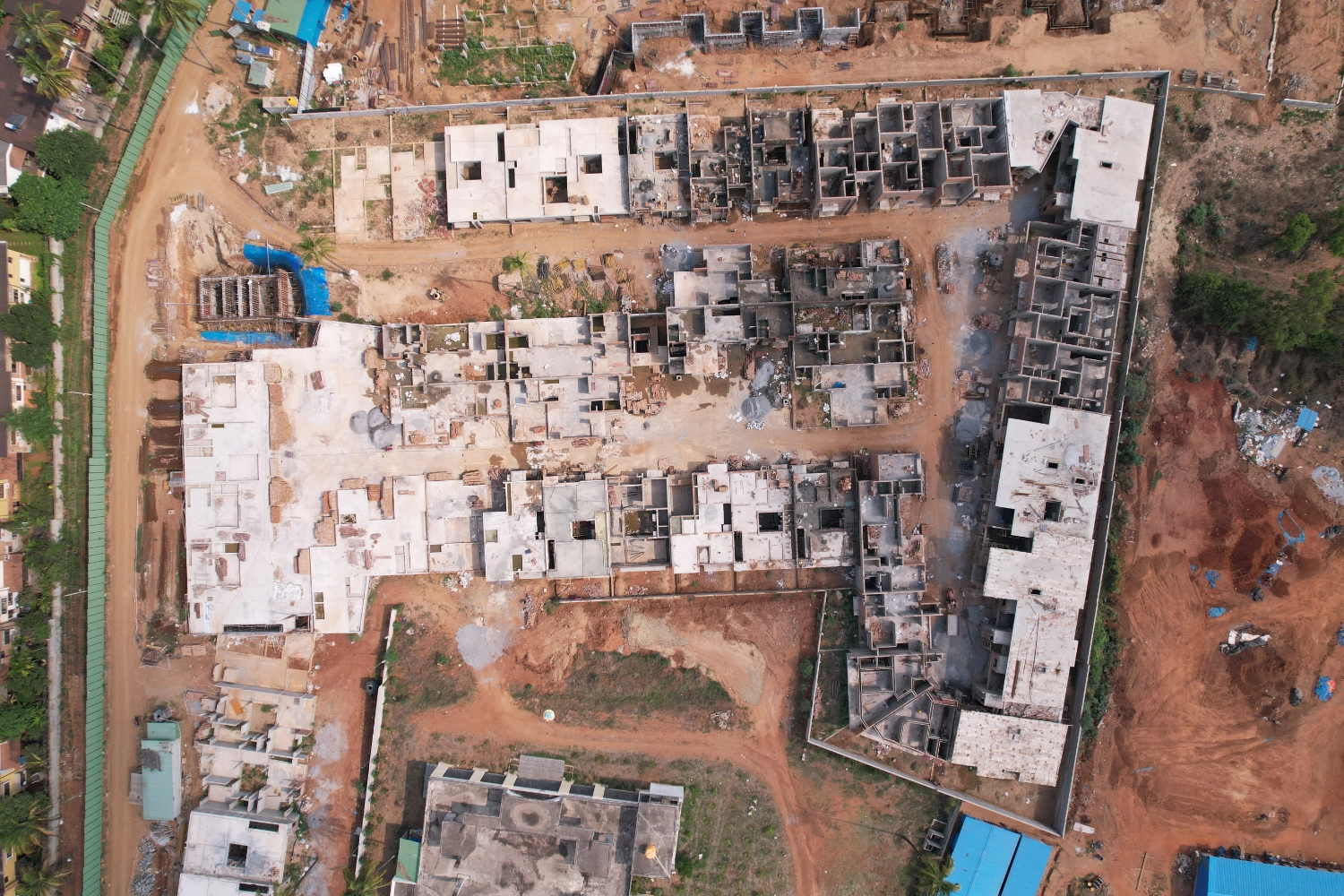

Here’s a quick aerial view of Malhar Octave.
360° View
Explore the site from wherever you are – here’s a 360° glimpse of the project.
A Quick Word from our Projects Team
" I'm pleased to highlight the significant progress we've made so far and outline its current status."
- CHANDRA . N
Project Engineer
What’s Next
Internal plastering work is scheduled to commence in 5 units, marking progress toward the finishing stages and preparing for subsequent interior activities.
Roof slab casting on the first floor is planned for 3 additional units, continuing the vertical expansion of the structure.
Ground floor roof slab work will also be carried out for 3 units, maintaining construction momentum across levels.
