Project progress this month

The foundation work for Blocks D to J has been completed, and the soil filling has also been carried out.

Excavation and levelling for Blocks C and K have been completed, and the foundation work is currently in progress.

asdfgh

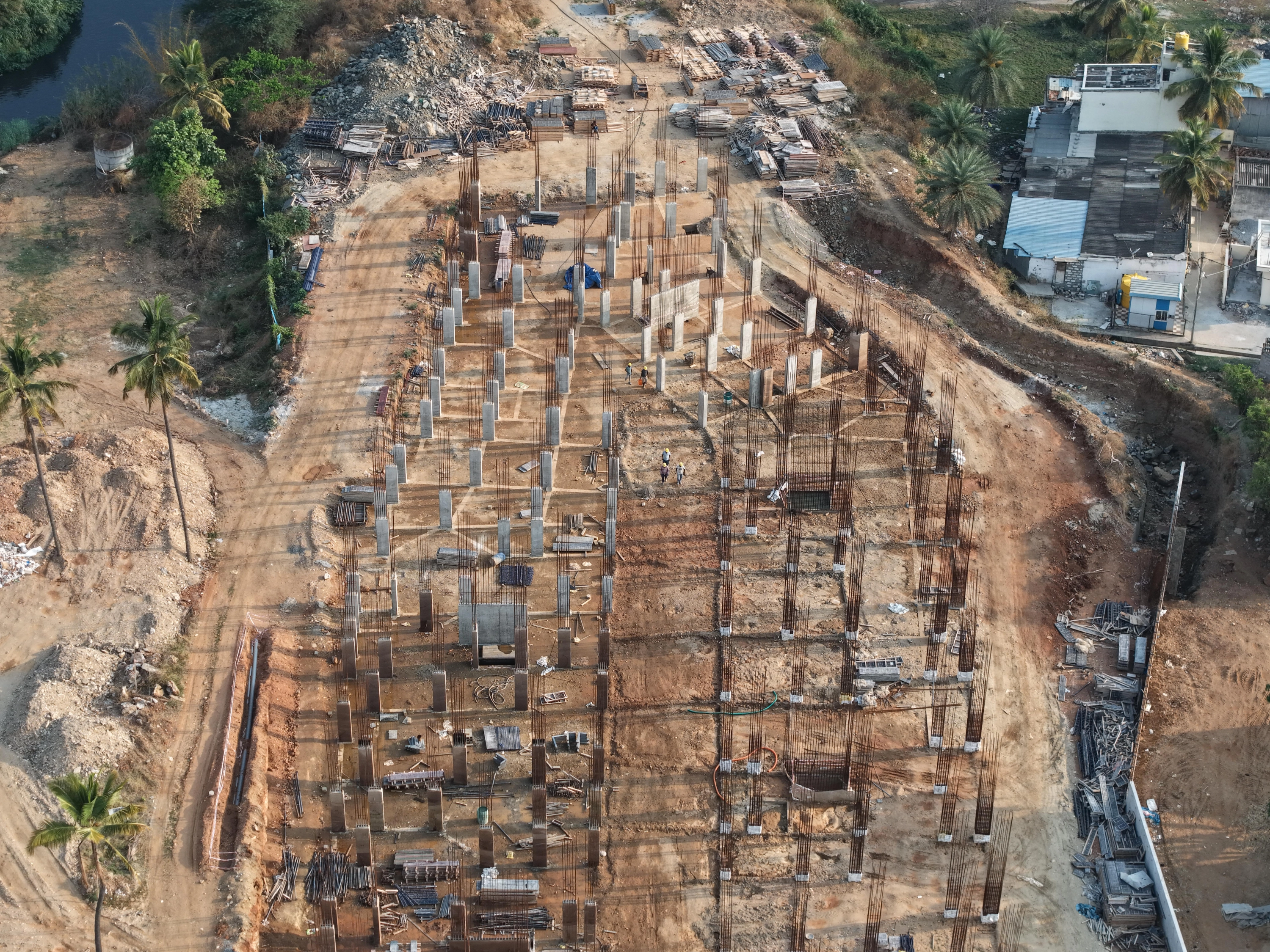

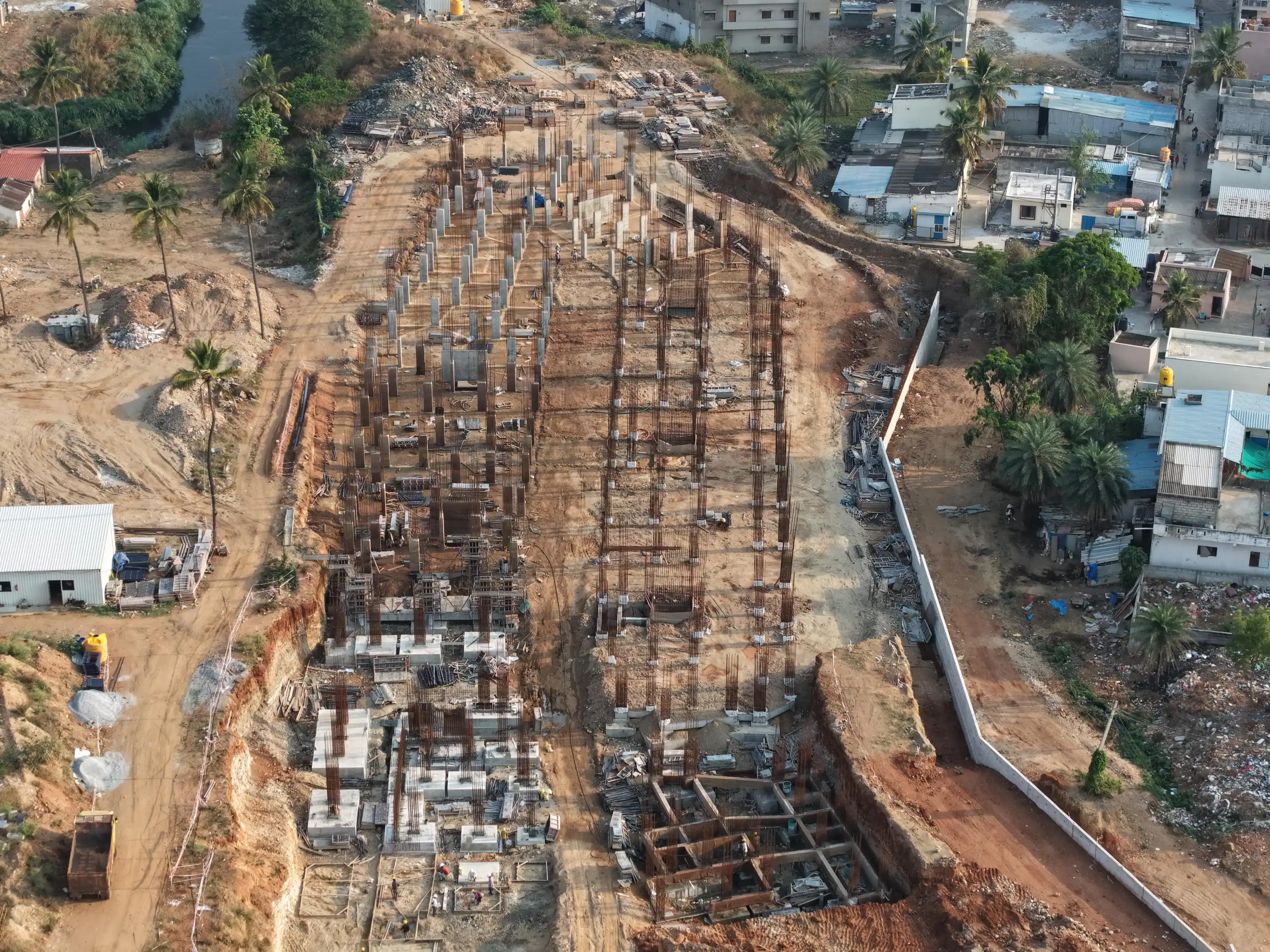

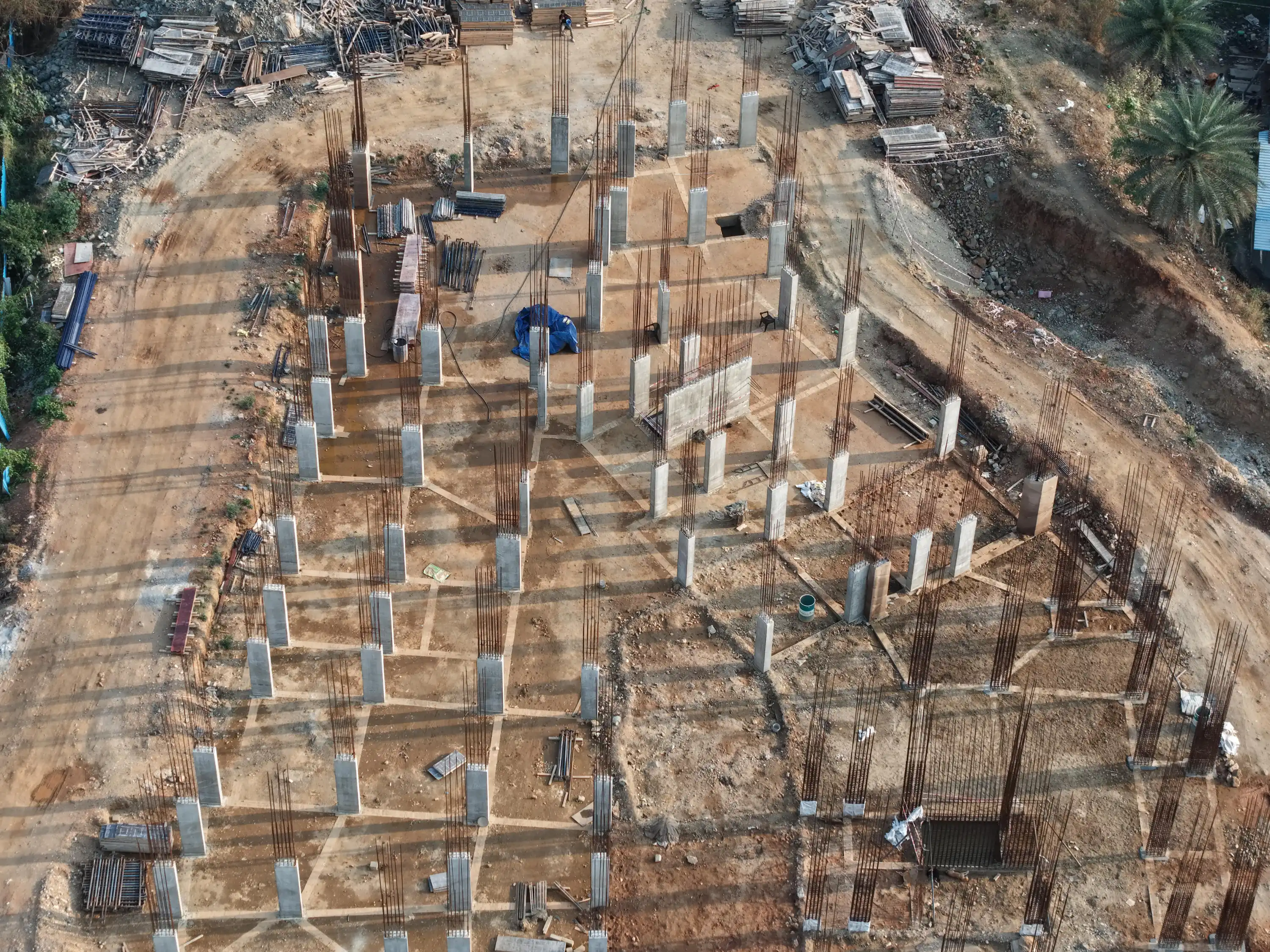

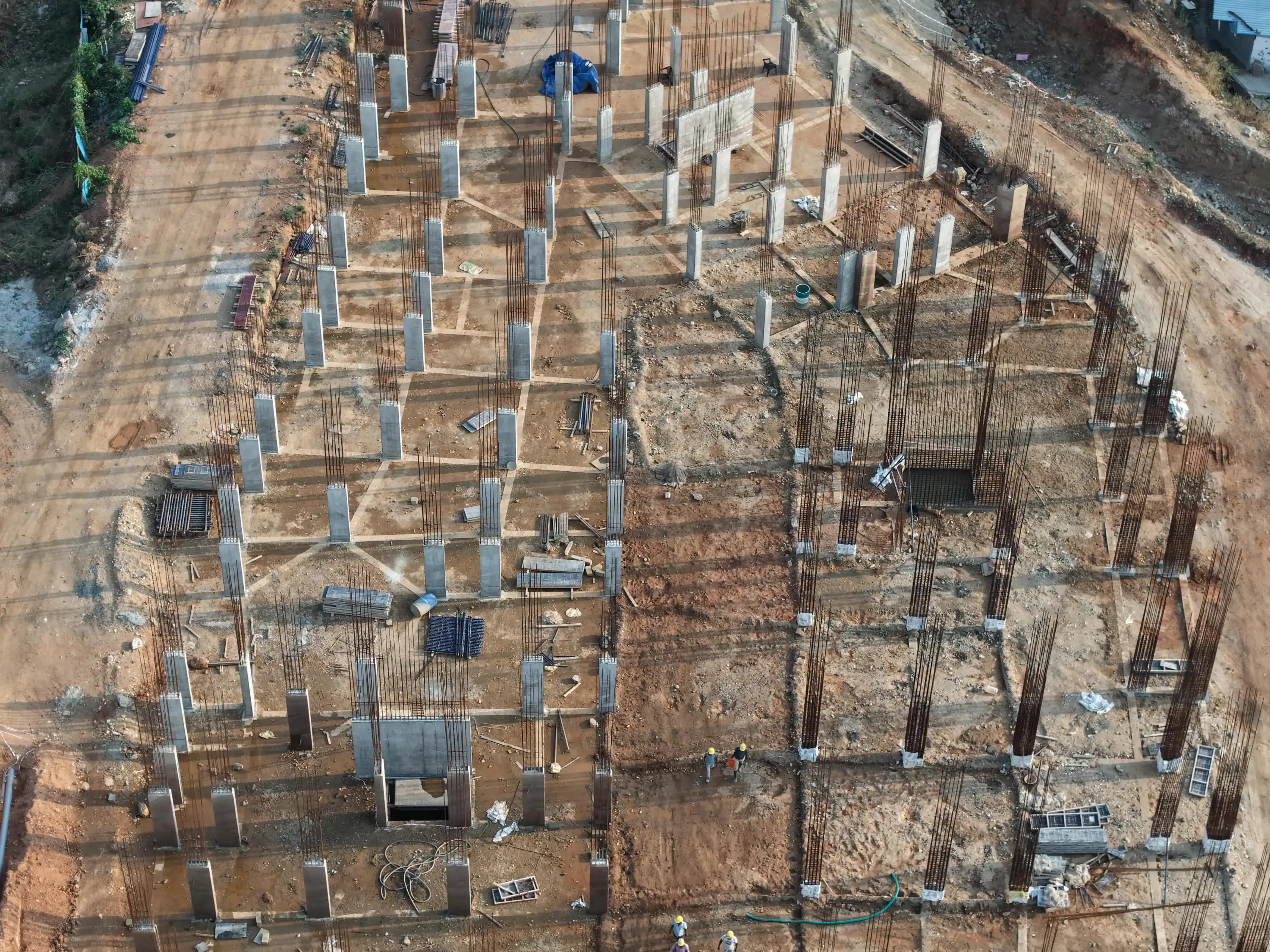

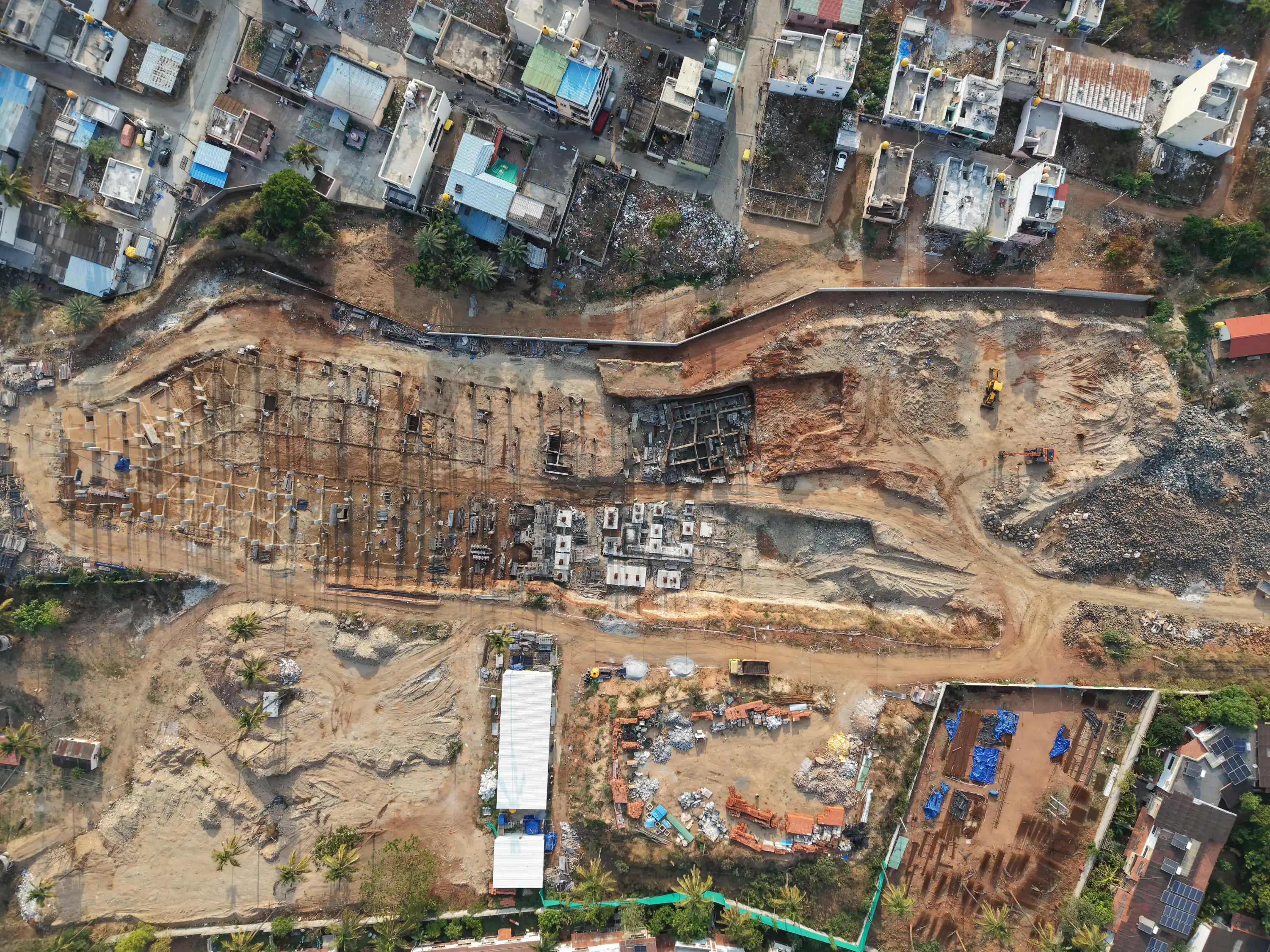

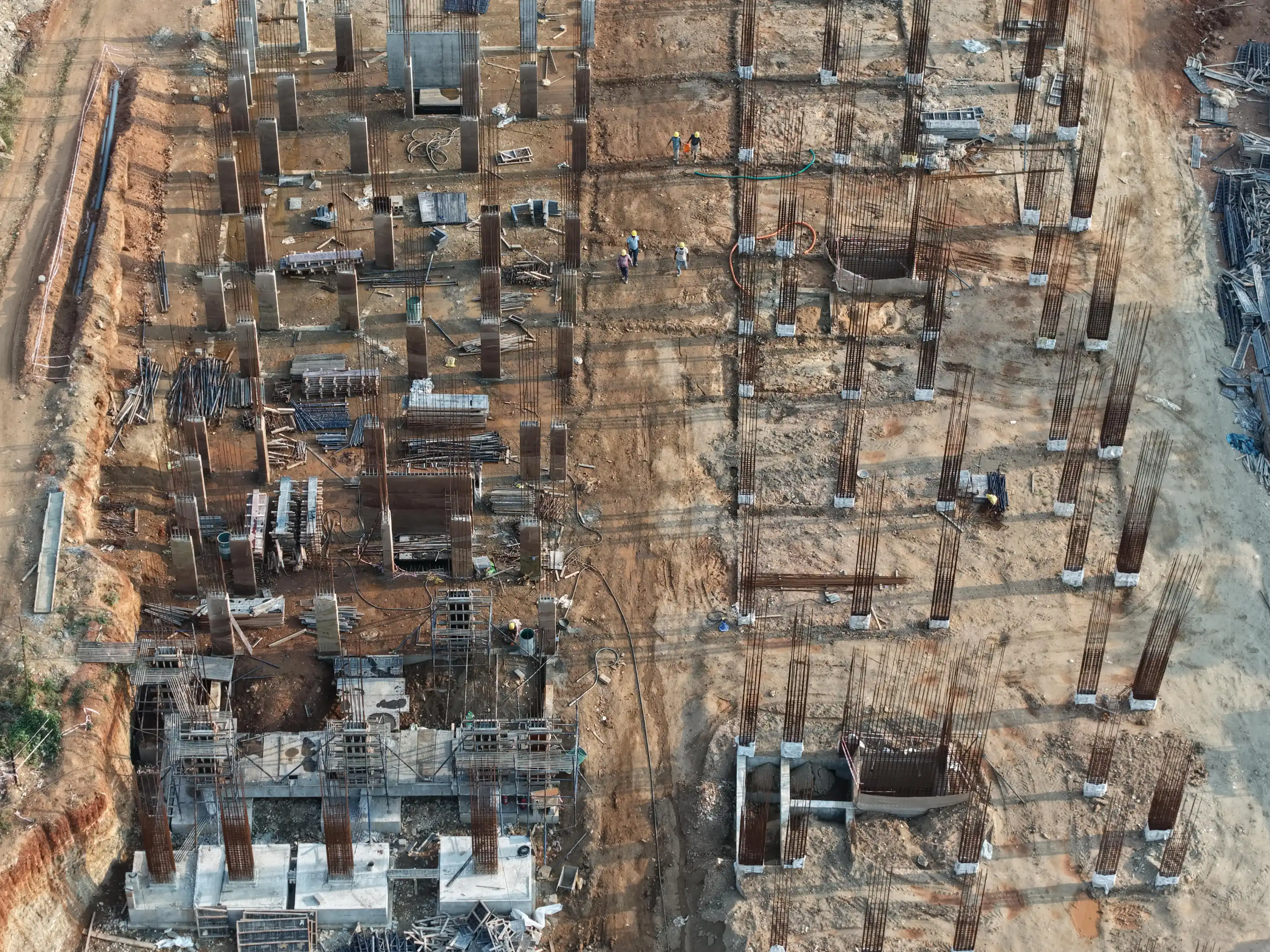

Drone’s Eye View

Here’s a quick aerial view.

360° View

Explore the site from wherever youare – here’s a 360° glimpse of where it all begins.

A Quick Word from our Projects Team

"I'm pleased to highlight the significant progress we've made so far and outline its current status."
- MANJUNATH UDBHALMATH
Assistant General Manager

What’s Next

In the upcoming month, excavation and levelling work for Blocks A, B, L, and M will be in progress.

Meanwhile, partial foundation work will commence for Blocks C and K, and the lower basement slab work is expected to begin by the end of April.
